Healthcare facilities face unique challenges when selecting furniture. Unlike office or hospitality environments, medical settings demand furniture that balances infection control, patient safety, ergonomic support, and durability—all while meeting strict regulatory standards.

For project managers, facility directors, and procurement officers, choosing the wrong furniture can result in compliance violations, increased maintenance costs, and compromised patient comfort. This guide covers everything you need to know about healthcare furniture procurement in 2026.

healthcare furniture design


Why This Guide Matters

Healthcare furniture is a specialized category with distinct requirements:

- Infection control: Materials must be antimicrobial and easy to disinfect

- Patient safety: Furniture must meet specific safety standards to prevent injuries

- Regulatory compliance: Healthcare furniture must adhere to regional and international standards

- Durability: Hospital-grade furniture faces heavy daily use and requires extended lifespan

Whether you're equipping a new hospital wing, renovating a clinic, or selecting furniture for an assisted living facility, this guide provides actionable insights for your procurement decisions.


1. Understanding Healthcare Furniture Categories

Healthcare furniture spans multiple categories, each serving specific functions within medical facilities.

1.1 Patient Room Furniture

Patient rooms require furniture that supports both clinical care and patient comfort:

Furniture Type

Primary Functions

Key Requirements

Hospital Beds

Patient rest, positioning, clinical care

Adjustable, safe, easy to clean

Patient Chairs

Visitor seating, patient comfort

Ergonomic, easy to disinfect

Overbed Tables

Meals, reading, personal items

Height-adjustable, stable surface

Bedside Cabinets

Storage for personal items

Easy to clean, secure

Patient Loungers

Extended seating for family

Comfortable, durable upholstery

patient Room Furniture

1.2 Clinical Furniture

Clinical areas demand furniture that supports healthcare workflows:

Category

Applications

Critical Features

Examination Tables

Patient examinations

Easy cleaning, patient access

Task Chairs

Nurses, physicians

Ergonomic, adjustable

Workstations

Documentation, charting

Cable management, adjustability

Storage Units

Medical supplies, records

Security, organization

Procedure Carts

Mobile equipment transport

Mobility, stability

Clinical Furniture

1.3 Waiting and Reception Areas

First impressions and patient comfort matter in waiting areas:

Furniture Type

Purpose

Design Considerations

Waiting Room Chairs

Patient/visitor seating

Easy cleaning, comfortable, varied sizes

Reception Desks

Check-in, information

Accessible design, security

Coffee Tables

Comfort accessories

Easy to move, clean

Magazine Racks

Information display

Organized, accessible

Children's Area

Young patient comfort

Safe, engaging, easy to clean

hospital Waiting and Reception Areas Furniture

1.4 Senior Care Furniture

Senior care facilities have distinct requirements beyond standard healthcare furniture:

Category

Requirements

Special Considerations

Assisted Living Beds

Low height, safety rails

Fall prevention, ease of access

Lift Chairs

Powered positioning

User-friendly controls

Dining Chairs

Height-appropriate, supportive

Easy transfer, stable

Grab Bars

Safety integration

ADA compliance, style coordination

Wheelchair-Accessible Tables

Inclusive design

Standard height, clear space

Senior Care Furniture


2. Material Standards for Healthcare Environments

Material selection is critical in healthcare furniture procurement. The wrong materials can harbor pathogens, trigger allergies, or fail prematurely.

2.1 Antimicrobial Surface Requirements

Healthcare furniture must inhibit bacterial growth:

Material Category

Antimicrobial Properties

Common Applications

Medical-Grade Vinyl

Naturally antimicrobial, easy to clean

Upholstery, exam tables

Stainless Steel

Corrosion-resistant, antimicrobial

Frames, carts, work surfaces

Solid Surface

Non-porous, seamless

Countertops, vanities

Anti-Microbial Laminate

Treated surface

Cabinetry, wall panels

Copper Alloys

Naturally antimicrobial

High-touch surfaces

2.2 Cleanability and Disinfection Compatibility

Healthcare furniture must withstand frequent disinfection:

Requirement

Standard

Testing Method

Chemical Resistance

Hospital-grade disinfectants

ASTM D543

Seam Integrity

No penetration points

Visual inspection

Surface Durability

Scratch and stain resistant

ASTM C501

Colorfastness

No fading with cleaning

AATCC 16

healthcare Furniture

2.3 Regulatory Standards

Healthcare furniture must meet specific regulatory requirements:

Standard

Region

Scope

ISO 9001

International

Quality management systems

ISO 13485

International

Medical device quality

EN 60601-1

Europe

Medical electrical equipment

UL 60601-1

North America

Medical equipment safety

CAL-133

California

Flammability of upholstered furniture

BS 7176

UK

Resistance to ignition


3. Evaluating Healthcare Furniture Suppliers

Choosing the right supplier is as important as selecting the right products. Use this comprehensive evaluation framework.

3.1 Supplier Qualification Checklist

Criteria

What to Verify

Red Flags

Industry Experience

5+ years in healthcare furniture

New company, generic furniture background

Healthcare Focus

Dedicated healthcare product lines

Primarily office/hospitality focus

Quality Certifications

ISO 9001, ISO 13485

No certifications or expired

Compliance Documentation

Test reports, certifications

Missing documentation

Manufacturing Capability

Own production facility

Complete outsourcing

Sample Quality

Physical samples for evaluation

Refusal to provide samples

References

Healthcare facility references

Unverifiable references

3.2 Financial Stability Assessment

Healthcare projects require reliable suppliers:

Financial Indicator

What to Check

Minimum Threshold

Business Registration

Legal entity status, years in business

5+ years

Financial Statements

Revenue, profitability trends

Consistent or growing

Insurance Coverage

Liability insurance

$2M+ general liability

Credit References

Supplier/partner references

Positive feedback

Warranty Backing

Financial capacity to honor warranties

Documented

3.3 Production and Delivery Capabilities

Capability

Evaluation Questions

Acceptable Standards

Lead Time

Standard vs. custom production time

4-12 weeks standard

MOQ Flexibility

Minimum order quantities

No excessive MOQs

Scalability

Can they handle project size?

100+ units capacity

Logistics

Shipping, installation capabilities

Turnkey options available

After-Sales Support

Warranty, spare parts, service

5+ year warranty standard

Woodlands Health Campus987_副本
Woodlands-Healthcare-Campus-Singapore-C-F-Moeller-img-50361-w1400-h907-tD_副本
220D099E-248D-46C3-9C5E-CE6F84B603A1_副本

Woodlands Health Campus0023_副本

Woodlands Health Campus | Medical Project Solution By Hongye Furniture



4. Cost Planning and Budgeting

Healthcare furniture represents a significant capital investment. Proper budgeting prevents costly mid-project changes.

4.1 Typical Budget Allocation

For a new hospital wing or major renovation:

Category

Percentage of Budget

Considerations

Patient Room Furniture

35-40%

Beds, seating, storage

Clinical Furniture

25-30%

Workstations, exam tables, storage

Waiting/Reception

10-15%

First impression areas

Staff Areas

10-15%

Break rooms, offices

Contingency

10%

Unexpected needs, replacements

4.2 Cost Comparison: New vs. Refurbished

Factor

New Healthcare Furniture

Refurbished Furniture

Initial Cost

Higher upfront

30-50% lower

Warranty

Full coverage

Limited or none

Infection Control

Certified new

Unknown history

Customization

Full options

Limited availability

Lead Time

Standard

Often faster

Total Cost of Ownership

Lower long-term

Higher maintenance risk

4.3 Hidden Cost Considerations

Budget for these often-overlooked expenses:

Cost Category

What to Include

Typical Range

Freight and Delivery

Shipping to site, handling

5-15% of order

Installation

Assembly, placement

3-8% of order

Inspection and Testing

Compliance verification

$1,000-5,000

Replacement Parts

Common wear items

5% of furniture cost

Disposal

Old furniture removal

Varies by quantity

Maintenance Contracts

Annual service plans

2-5% annually

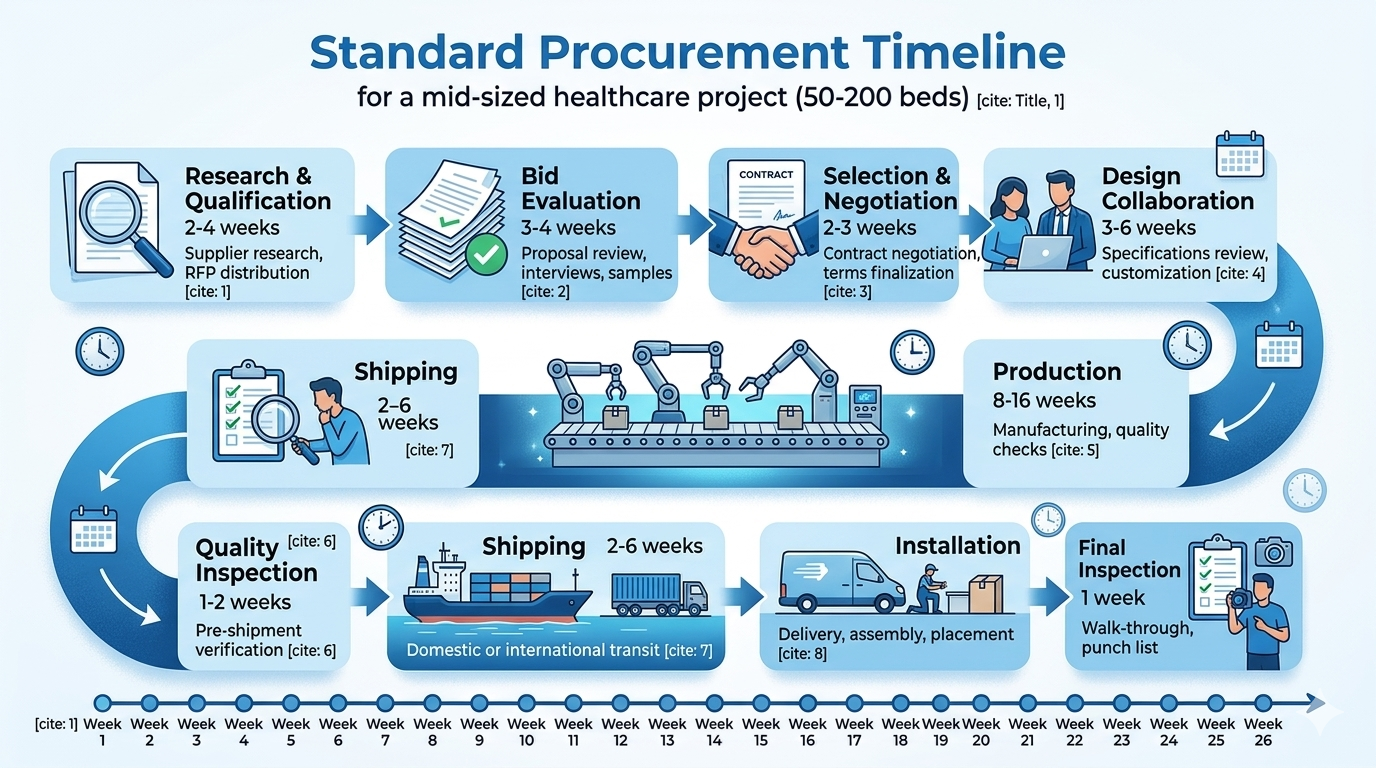

5. Procurement Process Timeline

Healthcare furniture procurement requires careful scheduling to avoid project delays.

5.1 Standard Procurement Timeline

For a mid-sized healthcare project (50-200 beds):

Phase

Duration

Key Activities

Research & Qualification

2-4 weeks

Supplier research, RFP distribution

Bid Evaluation

3-4 weeks

Proposal review, interviews, samples

Selection & Negotiation

2-3 weeks

Contract negotiation, terms finalization

Design Collaboration

3-6 weeks

Specifications review, customization

Production

8-16 weeks

Manufacturing, quality checks

Quality Inspection

1-2 weeks

Pre-shipment verification

Shipping

2-6 weeks

Domestic or international transit

Installation

2-4 weeks

Delivery, assembly, placement

Final Inspection

1 week

Walk-through, punch list

Standard Procurement Timeline

5.2 Risk Factors and Mitigation

Risk

Probability

Impact

Mitigation Strategy

Supplier bankruptcy

Low

High

Financial vetting, milestone payments

Quality issues

Medium

High

Sample verification, inspection protocols

Shipping delays

Medium

Medium

Buffer time, local backup options

Specification changes

Medium

Medium

Clear change order process

Regulatory non-compliance

Low

Critical

Pre-procurement compliance verification

Budget overruns

Medium

Medium

Contingency budget, value engineering



6. Installation and Commissioning

Proper installation ensures furniture performs as specified.

6.1 Pre-Installation Checklist

Item

Responsibility

Verification

Site readiness

General contractor

Floors level, walls finished

Receiving area

Facility management

Clear access, dock available

Storage space

Facility management

Climate-controlled if needed

Installation crew

Furniture supplier

Licensed, insured

Site supervision

Project manager

On-site presence

As-built documentation

Supplier

O&M manuals, warranty cards

6.2 Commissioning Requirements

Healthcare furniture may require formal commissioning:

Component

Commissioning Steps

Documentation

Electrical Furniture

Safety testing, grounding

Test reports

Powered Equipment

Function testing, controls

Operation verification

Casework

Alignment, door/drawer function

Installation checklist

Wall-Mounted Items

Secure mounting, load testing

Mounting verification

Infection Control

Surface inspection, cleanliness

Sanitation verification



7. Maintenance and Lifecycle Management

Healthcare furniture maintenance directly impacts facility hygiene and longevity.

healthcare patient room

7.1 Maintenance Schedule

Frequency

Tasks

Responsible Party

Daily

Surface cleaning, disinfection

Facility staff

Weekly

Deep cleaning, inspection

Facility staff

Monthly

Detailed inspection, hardware check

Maintenance staff

Quarterly

Professional cleaning, adjustments

Service technicians

Annually

Comprehensive inspection, repairs

Service technicians

Every 3-5 years

Major refurbishment or replacement

Facility management

7.2 Warranty Considerations

Warranty Type

Coverage

Typical Duration

Structural

Frame, construction defects

10-15 years

Finish

Surface finish, color

3-5 years

Upholstery

Fabric, stitching

2-3 years

Mechanisms

Adjustable parts, locks

3-5 years

Electrical

Motors, controls

2-3 years

7.3 End-of-Life Planning

Plan for furniture replacement before equipment fails:

Planning Element

Timeline

Actions

Replacement Research

12-18 months before end of life

Supplier evaluation, budgeting

Budget Allocation

6-12 months before

Capital planning, approval

Procurement Initiation

6 months before

RFP, supplier selection

Transition Planning

3-6 months before

Phasing, temporary solutions


8. Frequently Asked Questions

Q1: What are the most important factors when selecting healthcare furniture?

The most critical factors are infection control compliance, patient safety features, durability for heavy daily use, and regulatory compliance. Material selection is paramount—healthcare furniture must be made from antimicrobial, easy-to-disinfect materials that can withstand hospital-grade cleaners without degradation.

Q2: How do healthcare furniture standards differ from standard commercial furniture?

Healthcare furniture must meet stricter requirements for infection control, patient safety, and regulatory compliance. Key differences include antimicrobial materials, flame retardancy standards (CAL-133, BS 7176), ergonomic requirements for healthcare workers, and specific durability testing for healthcare environments.

Q3: What is the typical lifespan of healthcare furniture?

Quality healthcare furniture typically lasts 10-15 years with proper maintenance, though high-traffic items like waiting room chairs may need replacement every 5-7 years. Patient beds and clinical furniture often last 10+ years due to their robust construction.

Q4: How can we reduce healthcare furniture procurement costs without compromising quality?

Cost reduction strategies include bulk purchasing through group contracts, phased replacement instead of complete renovation, selecting modular furniture that allows future reconfiguration, and working with suppliers who offer value engineering services to optimize specifications without sacrificing essential requirements.

Q5: What certifications should healthcare furniture suppliers have?

Essential certifications include ISO 9001 (quality management), ISO 13485 (medical device quality where applicable), GREENGUARD certification for low chemical emissions, and region-specific flammability certifications (CAL-133 for California, BS 7176 for UK). Request documentation of all claims.


Conclusion

Healthcare furniture procurement requires careful attention to material quality, regulatory compliance, supplier qualifications, and lifecycle costs. Rushing this process can result in compliance violations, unexpected expenses, and compromised patient care environments.

Hongye Furniture brings over a decade of experience supplying healthcare facilities worldwide. Our medical-grade furniture meets international standards and is backed by comprehensive warranties and support.

Visit us at NeoCon 2026 (June 8-10, Chicago) at Booth 7-1114 to see our healthcare furniture collections firsthand. Our team will help you develop a procurement plan that meets your facility's needs and budget.

Table of Content list

Contact Us

If you have any questions, please contact us and we will reply to you as soon as possible. Thanks!
 No.1 Section, Heshan Industrial City, Heshan Town, Jiangmen City,
 Guangdong, China
  +86-13702279783
FEEDBACK
HONGYE is a renowned furniture manufacturing enterprise with over 30 years of industry experience.
MENU
Copyright  2024 Hongye Furniture Group Co., Ltd. All Rights Reserved.
